Edexcel IAL - Decision Mathematics 1- 4.1 Activity Networks and Precedence Tables- Study notes  - New syllabus

Edexcel IAL – Decision Mathematics 1- 4.1 Activity Networks and Precedence Tables -Study notes- New syllabus

Edexcel IAL – Decision Mathematics 1- 4.1 Activity Networks and Precedence Tables -Study notes -Edexcel A level Maths- per latest Syllabus.

Key Concepts:

  • 4.1 Activity Networks and Precedence Tables

Edexcel IAL Maths-Study Notes- All Topics

Activity Networks (Activity-on-Arc)

An activity network is used to model a project by showing the order in which activities must be carried out. In this syllabus, projects are modelled using an activity-on-arc (AOA) network.



The network is constructed from a precedence table, which lists each activity together with its immediate predecessors.

Activity-on-Arc Representation

In an activity-on-arc network:

  • Activities are represented by arrows (arcs)
  • Events (start or finish points) are represented by nodes
  • The direction of an arrow shows the order of activities

Each activity must start only after all its immediate predecessors have been completed.

Precedence Tables

A precedence table lists:

  • The activity label
  • The immediate predecessor(s) of that activity

Only immediate predecessors are shown. Indirect dependencies are not listed.

Dummy Activities

A dummy activity is an activity with:

  • No duration
  • No resource requirement

Dummy activities are used to:

  • Preserve correct precedence relationships
  • Avoid ambiguity in the network

They are usually shown as dashed arrows.

Rules for Drawing an Activity Network

  1. Each activity must be represented once only
  2. No two activities may have the same start and finish nodes
  3. The network must flow from left to right with no cycles

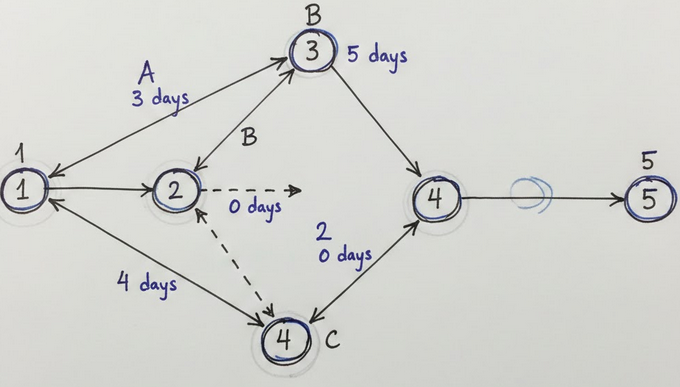

Example :

The precedence table below describes a project:

A: none

B: A

C: A

Draw an activity-on-arc network.

▶️ Answer/Explanation

Activity A starts at the initial node.

Activities B and C both start after A finishes.

Conclusion: The network has A first, followed by B and C in parallel.

Example :

A project has the following precedence table:

A: none

B: A

C: A

D: B, C

Explain why a dummy activity is required.

▶️ Answer/Explanation

Activity D must not start until both B and C are completed.

A dummy activity is needed to show this dependency without creating ambiguity.

Conclusion: The dummy ensures D depends on both B and C.

Example :

Explain why a precedence table showing only immediate predecessors is sufficient to construct an activity network.

▶️ Answer/Explanation

Immediate predecessors already include all necessary ordering information.

Indirect dependencies are automatically enforced through the network structure.

Conclusion: Listing immediate predecessors is sufficient.
